Hip-to-Gable Conversion

Chelsea Townhouse

SW3, London · 2023

A hip-to-gable and rear dormer conversion to a Grade II townhouse in Chelsea, delivering a private principal suite with dressing room, bathroom and study alcove.

Chelsea Townhouse — Hip-to-Gable Conversion
Type
Hip-to-Gable Conversion
Added floor area
540 sq ft
Bedrooms added
1
On site
16 weeks

The brief

The clients had bought a beautifully proportioned but tightly planned townhouse and wanted their principal bedroom moved to the top of the house — away from the street and from their teenage children. They asked for a suite that felt like the top floor of a small hotel: private, hushed, with a bathroom worth pausing in.

The challenge

Grade II listing, party wall complexity on both sides, and a client in residence throughout. Every material and detail had to be signed off by the conservation officer, and every delivery choreographed around a narrow mews access. The neighbours' cooperation was essential, and earning it took months of careful conversation before a single brick was moved.

Our response

We rebuilt the gable in reclaimed London stock brick, hand-picked to match the age and colour of the terrace, and inserted a slim steel goalpost frame that let us achieve a clear span across the whole floor. The bathroom is finished in book-matched Carrara and unlacquered brass; the dressing room in fumed oak. A hidden riser inside the chimney breast carries the new services down through the house without disturbing a single cornice on the floors below.

Location & context

The house sits on one of Chelsea's most tightly listed streets, off the King's Road. Every property in the terrace is Grade II, the entire road is within the Cheyne Conservation Area, and access is via a single narrow mews entrance shared with three other households.

The project, in full

How it came together.

The listed building consent process took almost twice as long as the build itself. We prepared a full heritage statement, sample panels of six different reclaimed brick blends, and a materials board that the conservation officer described as 'the most thorough she'd seen from a contractor'. Consent was granted first time with only one minor condition.

Deliveries were the quietest part of the job. A dedicated logistics manager coordinated with the three neighbouring households by WhatsApp — every skip, every scaffold lift, every arrival of the crane. Not a single complaint was received during the sixteen-week programme.

The finishing work is what the clients quote most often. The book-matched Carrara vanity was slabbed in Verona and shipped whole; the brass ironmongery was hand-turned in Birmingham; the joinery was fumed on site over three days to achieve exactly the colour the client had seen in a photograph of a Milanese bookshop.

Gallery

A quiet walk through the finished home.

Chelsea Townhouse bathroom with Carrara marble, brass fittings and skylight
Bathroom in Carrara and unlacquered brass
Principal bedroom with oatmeal linen bed beneath a pitched ceiling and skylight
Principal bedroom — lime-washed walls, linen, soft skylight
Walk-through dressing room with bespoke pale oak wardrobes and marble-topped island
Dressing room — bespoke oak joinery and marble
Rear elevation of Chelsea townhouse with rebuilt brick gable and zinc dormer at dusk
Rear elevation — rebuilt gable, quiet zinc dormer

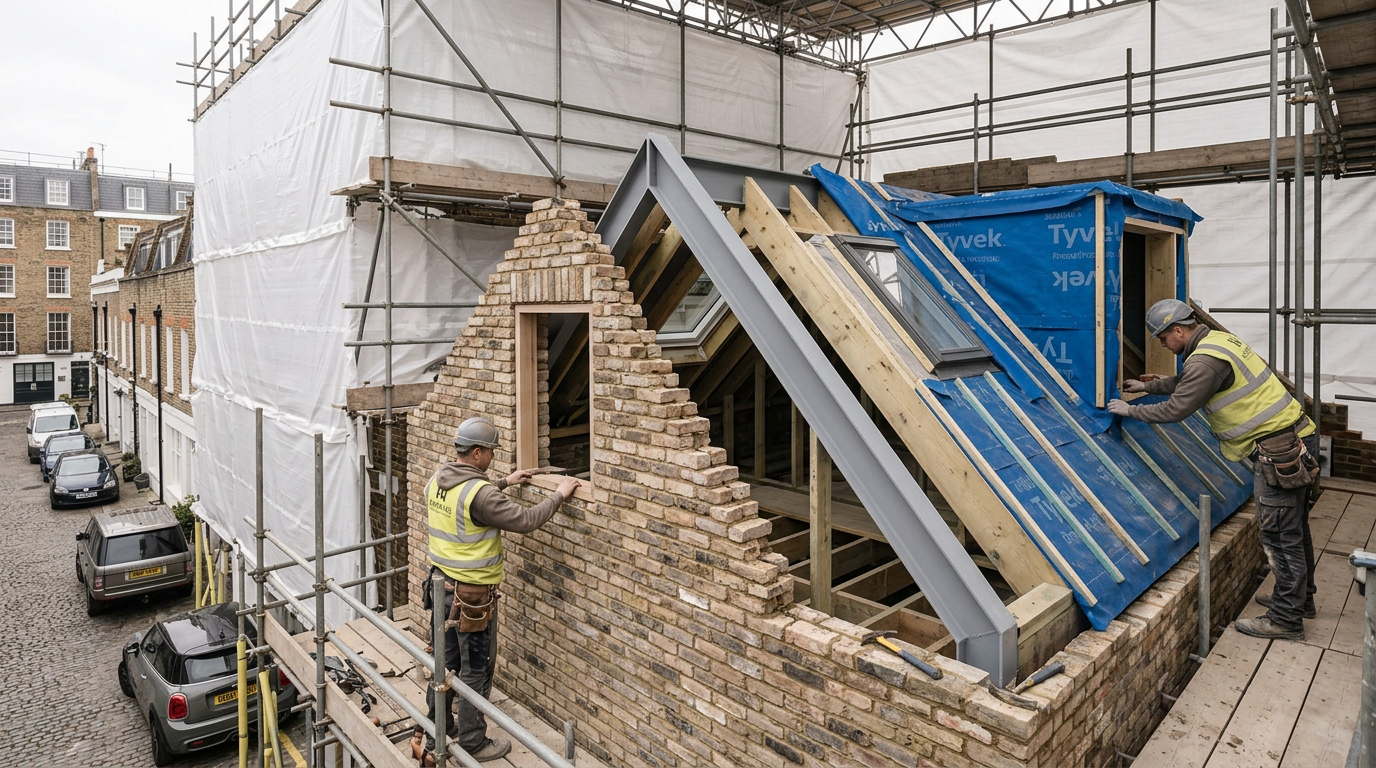

Chelsea townhouse loft under construction with rebuilt brick gable and new dormer frame
Mid-build — gable rebuilt by hand, dormer taking shape

Materials & finishes

  • Reclaimed London stock brick
  • Book-matched Carrara marble
  • Fumed European oak joinery
  • Unlacquered brass fittings
  • Hand-blocked wallpaper (study alcove)
  • Traditional lime mortar
  • Restored cast-iron rainwater goods

Services delivered

  • Heritage and planning
  • Listed building consent
  • Party wall coordination
  • Structural engineering
  • Full build and project management
  • Stone and marble installation
  • Interior finishing

Programme

16 weeks on site.

Design and consents ran ahead of the build; the on-site programme was planned week by week.

  1. 01

    Design, heritage and listed building consent

    22 weeks
  2. 02

    Party wall awards

    Both boundaries

    10 weeks
  3. 03

    Strip-out and structure

    4 weeks
  4. 04

    Gable rebuild and weathering

    3 weeks
  5. 05

    First fix, plaster and services

    4 weeks
  6. 06

    Second fix, stone, joinery and finishing

    5 weeks

Sustainability

The rebuild used only reclaimed brick and lime mortar — both breathable, both compatible with the historic fabric. Original slates and rainwater goods were removed carefully, restored and reinstated. New services were routed to avoid any disturbance to historic plaster on the lower floors.

Credits

Design and delivery
Elisha Homes
Heritage consultant
Camberwell Heritage
Structural engineer
Whitby Wood, London
Party wall surveyor
Anstey Horne
Stonework
Marmi di Verona

In the client's words

Sixteen weeks of building work in a listed London house, with us still living in it, and we barely noticed. Extraordinary discipline.
Ms. R. · Homeowner, SW3
